Drilling or building before a required permit issues is a violation. The federal rules are also moving in 2026, including EPA’s October 29 proposal to amend its oil and gas emission standards. The US Environmental Protection Agency (EPA) has proposed suspending Subpart W, its oil and gas greenhouse gas reporting rule, until 2034.

A permit is a written approval from a government agency to carry out a regulated activity, such as drilling a well or injecting fluid underground. The problem is that a United States (US) well or compressor station needs authorizations from several agencies, under different laws, some before work starts. The scale is large: about 180,000 Class II wells, which inject only fluids associated with oil and natural gas production, operate under the injection program alone [1].

Operators asking what permits a site needs usually want three things: the list, who issues each item, and the order. This post answers all three for operators, engineers and compliance staff at production and midstream sites, including compressor stations and gathering lines. Water withdrawal, waste pits and road permits get less depth; each state sets those differently.

Quick Answer: Onshore wells generally need a state drilling permit; many sites also need an air authorization and a spill prevention plan. Federal rules require authorization for disposal and enhanced-recovery wells and bar building a permit-required well before the permit issues; primacy states have their own rules [2]. A site discharging entirely oil and gas stormwater needs no federal permit application, barring a reportable-quantity discharge or a contribution to a water quality violation [3]. The operator prepares the spill prevention plan and a Professional Engineer certifies it, unless a qualified facility self-certifies; no agency issues it [4].

On this page

The Permits and Plans an Oil and Gas Site Needs

A producing well site typically answers to a state oil and gas agency, a state air agency and EPA. Some requirements reach almost every site; others apply only when it does something specific, such as injecting fluid or filling a wetland. The table lists both.

RequirementIssued byWhen it applies
Drilling permitState oil and gas agency; on federal leases, also an Application for Permit to Drill (APD) from the Bureau of Land Management (BLM), the federal agency that approves drilling there; on Indian leases, a BLM APDEach new well, deepening or re-entry; BLM approves deepening on Form 3160-5, its Sundry Notices and Reports on Wells form
Preconstruction air authorizationState or local air agency; the form varies by stateEmitting equipment the state’s minor source rules cover
Spill Prevention, Control, and Countermeasure (SPCC) plan, a written plan to prevent oil spillsNot issued; prepared by the operator, certified by a licensed Professional Engineer or self-certifiedOil storage above the capacity threshold where a discharge could reach navigable waters
Underground injection permitState or tribal Underground Injection Control (UIC) program, which regulates injection wells, or EPADisposal or enhanced-recovery injection
Title V of the Clean Air Act operating permit, for large air pollution sourcesState air agency, or EPAMajor sources (100 short tons a year, lower in some nonattainment areas and the Ozone Transport Region, or 10 of one hazardous air pollutant or 25 combined), plus some sources under federal emission standards
Stormwater permitState water agency or EPAAfter a reportable-quantity discharge or a water quality violation, or where a state rule requires it. Produced water and other process wastewater are not stormwater; onshore, 40 CFR 435.32 bars their discharge to navigable waters except as Part 435 allows
Section 404 permit, the Clean Water Act permit for dredged or fill materialUS Army Corps of Engineers; the state in Michigan and New Jersey, except Corps-retained navigable waters and adjacent wetlandsFill placed in waters of the US, such as a pad, road or pipeline crossing
Emissions reporting under the Greenhouse Gas Reporting Program (GHGRP), EPA’s annual report from large emittersReport to EPA; no permitFacilities under Subpart W, the GHGRP section for petroleum and natural gas systems, at 25,000 metric tons or more a year of carbon dioxide (CO2) equivalent (CO2e: each gas counted as the CO2 with the same warming effect), from production and gathering (per basin) to processing and compression

Rows one to three reach many producing sites; the others turn on what the site does or how large it is.

EPA has proposed removing all source categories except Subpart W, removing Subpart W’s gas distribution segment, and suspending the remaining segments until reporting year 2034.

For reporting year 2023, EPA’s published GHGRP data shows 2,298 petroleum and natural gas systems facilities reported 322 million metric tons CO2e [5]. In separate rules, EPA moved the reporting year 2025 deadline from March 31 to October 30, 2026, and then to March 10, 2027 [2] [3].

Under the same interim final rule, comments on the March 10, 2027 deadline are open until November 30, 2026 [6]. As of November 3, 2026, the Federal Register showed no final EPA action on the September 2025 proposal [7].

Some Requirements Are Not Permits at All

Operators often expect the spill prevention rule to issue a permit, but it does not. The rule sits at 40 CFR Part 112, EPA’s oil pollution prevention rule under the Clean Water Act [8]. 40 CFR is Title 40 of the Code of Federal Regulations [9].

Part 112 applies to facilities that drill, produce, gather, store or process oil and could reasonably discharge it to navigable waters [8]. One exemption covers such a facility if its aboveground storage is 1,320 US gallons or less, counting only containers of 55 gallons or more [8]. Its completely buried storage must also be 42,000 gallons or less [8].

The operator writes and implements a Spill Prevention, Control, and Countermeasure (SPCC) plan; a licensed Professional Engineer certifies it unless the facility qualifies to self-certify [4]. Unlike some other federal environmental programs, EPA cannot delegate SPCC to the states [10].

A missing permit leaves a gap in an agency’s register.

A missing SPCC plan does not, because the plan is kept at the site or nearest field office, not filed [4]. EPA can ask to see it during working hours [4].

A discharge to water of over 1,000 gallons, or two of over 42 gallons within twelve months, triggers a report [11]. The operator sends EPA’s Regional Administrator set facility and discharge details within 60 days [11]. An oil discharge is harmful if it breaches water quality standards, leaves a sheen, or leaves sludge or emulsion below the surface or on shorelines [12]. A harmful discharge must be reported to the National Response Center immediately [12].

Whether the rule applies at all is covered in SPCC Plan Requirements: Do You Need One, and Which Tier?.

Most Permits Come From the State, With Clear Exceptions

Several of these programs are federal laws run by states under EPA approval, so most applications go to a state agency. The exceptions matter: the application goes to EPA, the Corps of Engineers or no one.

Drilling permits, spacing and pooling are state programs outright. Permits under Title V of the Clean Air Act are the operating permits for large air pollution sources [13]. Most are “issued by state or local agencies,” with a small number issued by EPA [13].

EPA runs the injection program for all classes in Hawaii, Iowa, Minnesota, New York, Pennsylvania, Virginia, the District of Columbia and three territories [14]. It does the same in Indian country, apart from the Navajo Nation and Fort Peck Class II programs [14]. Disposal wells make up about 20 percent of Class II wells, and enhanced recovery wells as much as 80 percent [1].

In New Mexico, the Oil Conservation Division (NMOCD) regulates oil and gas activity, including permits for new wells [15]. In Colorado, the Energy and Carbon Management Commission (ECMC) is the former Oil and Gas Conservation Commission, renamed with a wider remit on July 1, 2023 [16]. How the two states run their drilling permits, and where the records sit, is covered in NMOCD Permitting: Find and Map New Mexico Drilling Permits and Colorado Well Permit Search: Where ECMC Keeps the Records.

National Pollutant Discharge Elimination System (NPDES) permits cover point sources discharging pollutants to US waters under the Clean Water Act [17]. NPDES stormwater and wastewater permits are state-run in most states [18]. EPA issues them where no state program is authorized, including New Mexico, Massachusetts, New Hampshire and the District of Columbia [18].

In Oklahoma, EPA also issues them for oil and gas activities, which fall outside the approved state agencies’ jurisdiction [18]. On tribal lands, EPA keeps authority to run the NPDES program in almost all cases [18].

State programs can be stricter than federal rules; Class II programs approved under Safe Drinking Water Act section 1425 need not match them.

Each Program Measures Something Different

The table shows each trigger and rule.

ProgramThe triggerWhere it is set
Spill prevention (SPCC)Above 1,320 gallons aboveground (counting containers of 55 gallons or more) or 42,000 gallons completely buried, at a facility that could discharge oil to navigable waters40 CFR 112.1, the section of Part 112 that says who it covers
Title V operating permitPotential to emit 100 short tons a year of a pollutant, or 10 of one hazardous air pollutant or 25 combined; lower in some nonattainment areas40 CFR 70.2, the definitions section of Part 70, the federal Title V permit rule
Federal preconstruction review: Prevention of Significant Deterioration (PSD), for new major air sourcesA new major source in an attainment or unclassifiable area: 250 short tons a year, or 100 for listed categories; major modifications are also reviewed. For a nonattainment pollutant, nonattainment new source review applies instead, at 100 short tons a year or less (10 for volatile organic compounds in extreme ozone areas)40 CFR 52.21, the federal PSD rule; 40 CFR 51.165 for nonattainment review
Underground injectionInjecting fluid through a well, except natural gas storage and non-diesel hydraulic fracturing for oil, gas or geothermal production; by permit or by rule40 CFR 144.11, the ban on unauthorized injection; the natural gas storage and hydraulic fracturing exclusions are in the Safe Drinking Water Act, 42 U.S.C. 300h(d)(1)
StormwaterA reportable-quantity discharge, or runoff contributing to a water quality standard violation; a state may require more under its own law40 CFR 122.26, the stormwater permit section
Greenhouse gas reporting25,000 metric tons CO2e a year40 CFR 98.231, the Subpart W reporting threshold

Potential to emit is “the maximum capacity of a stationary source to emit” under its physical and operational design, not a measured rate [19]. Well sites below the major-source lines may fall under state minor source review; each state’s plan identifies which types and sizes of facilities it covers [20]. The thresholds are covered in Air Quality Permit Types: Title V, PSD, and Their Thresholds.

Part 70 makes one exception for wells when it counts hazardous air pollutants against its 10 and 25 tons per year thresholds [19]. Emissions from a production well and its equipment “shall not be aggregated with emissions from other similar units,” even under common control [19]. Pipeline compressor and pump stations get the same treatment [19]. The exception sits in the hazardous air pollutant paragraph; the 100 short tons a year test for other pollutants has no such exception.

Stormwater is runoff from rain and snowmelt that flows over land or paved surfaces instead of soaking in [21]. Section 402(l)(2) of the Clean Water Act bars EPA from requiring a permit for uncontaminated stormwater from oil and gas exploration, production, processing, treatment or transmission [22]. The same section bars EPA from making a state require one, though a state may still require one under its own law.

The exemption turns on contact [3]. The rule requires an application after a reportable-quantity discharge of oil or a hazardous substance, or where runoff contributes to a water quality standard violation [3].

For a detailed breakdown of injection well classes, including Class VI wells, which inject carbon dioxide for long-term underground storage, see: UIC Well Classes: Class II, Class VI, and Where to Look [23].

Midstream Operations Add Pipeline and Interstate Permits

Midstream sites (compressor stations, gas processing plants and gathering lines) face the same air, spill-plan and wetland tests, each where its trigger is met.

Pipeline safety rules at 49 CFR Part 192 sort onshore gas gathering lines into types by location class, operating stress and diameter [24]. A location class counts buildings intended for human occupancy within 220 yards either side of a mile of pipe; Class 1 has 10 or fewer [25]. Lines meeting no type’s test are Type R, carrying reporting duties but not regulated under Part 192 [24].

Type A lines must meet Part 192’s transmission-line requirements, with a listed set of exceptions [26]. New or changed Type B lines must follow transmission-line design rules, and metallic Type B lines need corrosion control [26]. Type B operators also run damage prevention and public education programs, set a maximum allowable operating pressure, keep line markers and conduct leakage surveys [26].

Type C lines are 8.625 inches or more in outside diameter, in Class 1 locations, and meet a stress or pressure test [24]. Type C lines need damage prevention, emergency plans and, with exceptions, corrosion control, markers, leak surveys and, above 12.75 inches, maximum allowable operating pressure records [26].

An interstate gas pipeline needs a Federal Energy Regulatory Commission certificate [27]. The Natural Gas Act exempts production and gathering [28]. Pipeline crossings of streams and wetlands can use the Corps of Engineers’ Nationwide Permit 12, subject to its conditions [29]. The permit covers up to half an acre of waters lost per single and complete project; each separate and distant pipeline crossing counts as one [29].

Get regulatory updates and emissions data insights in your inbox. Subscribe to the TetraSoft newsletter.

Permit Order Is Where Oil and Gas Projects Usually Go Wrong

The order matters because several permits must be held before the work they govern. The chart shows when each requirement applies.

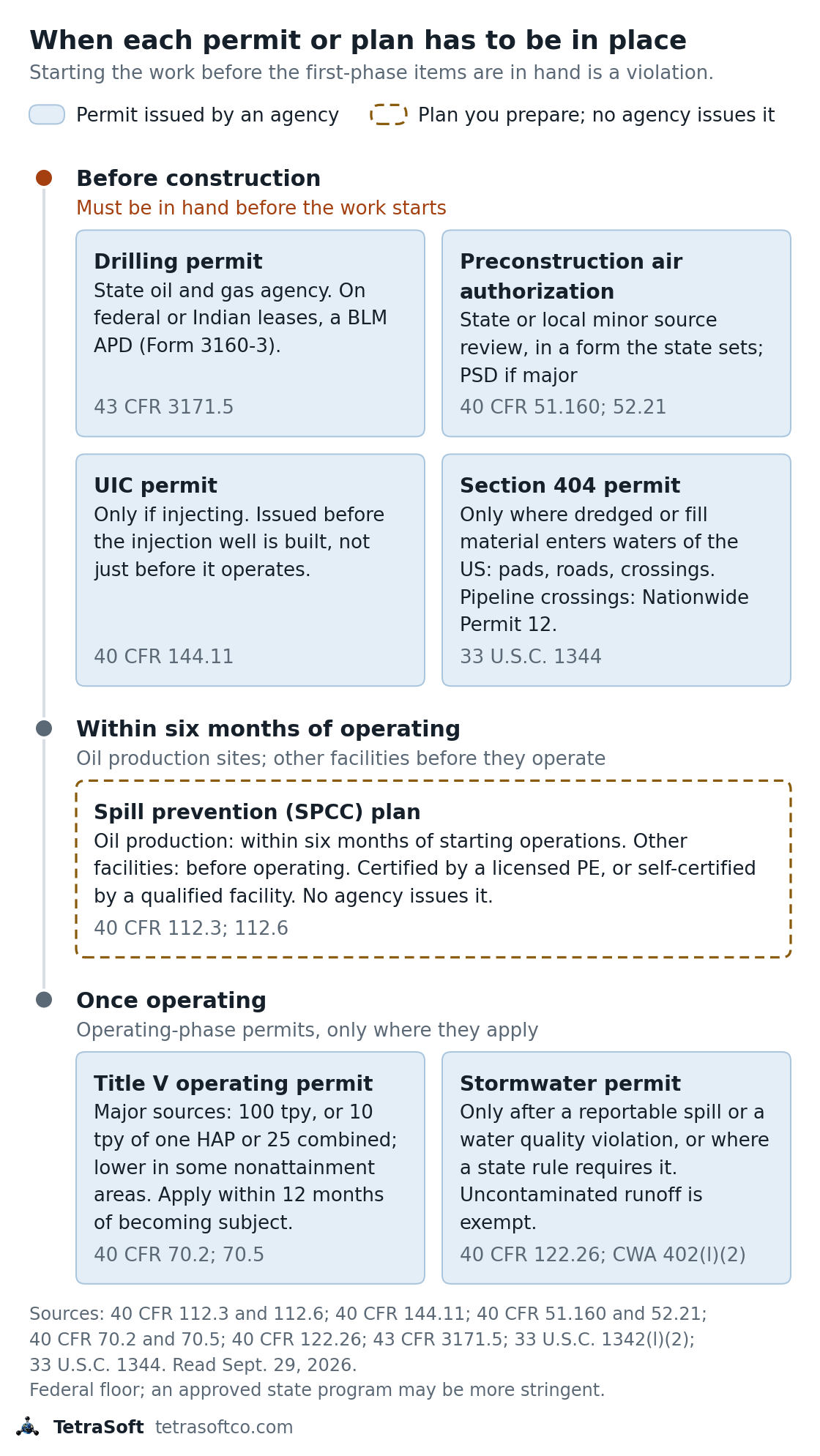

Timeline of when each oil and gas permit or plan must be in place. Before construction: the drilling permit, plus a BLM APD on federal or Indian leases; preconstruction air authorization; a UIC permit if injecting; and a Section 404 permit where fill enters waters of the US. Within six months of an oil production facility starting up, or before other facilities operate: the SPCC plan, prepared by the operator, certified by a Professional Engineer or self-certified by a qualified facility, and not issued. Once operating: Title V for major sources, and a stormwater permit after a reportable-quantity discharge or water quality violation, or under a state rule.

Construction Permits Come Before Construction

A drilling permit authorizes drilling, so it precedes the rig. On federal or Indian leases, an Application for Permit to Drill covers each well [30]. Federal rules bar building an injection well that needs an Underground Injection Control (UIC) permit until the permit issues [2].

Where a state requires a preconstruction air permit, building first is a violation too. State plans must include procedures to decide, before construction, whether a new facility would violate air rules [20]. A major source may not “begin actual construction without a permit” under federal Prevention of Significant Deterioration (PSD) [31].

The operating-phase items come after. An oil production facility has six months after it begins operations to implement its SPCC plan; other facilities need one before operating [4]. A new major source must apply within 12 months of becoming subject to Title V, or sooner if the permitting authority sets an earlier date [32].

What Changes When a Site Is Modified

A modification can restart several of these tests. Federal preconstruction review asks about the emissions increase a major modification produces, not the facility total [31]. Adding storage can cross the SPCC capacity threshold on its own [8].

An existing SPCC plan must also be amended when a change materially affects the facility’s potential to discharge oil [33]. The safest course: re-check every trigger, from storage capacity to potential to emit, after any physical change.

Frequently Asked Questions

Who issues oil drilling permits?

The state oil and gas agency issues them, such as the Railroad Commission in Texas or the Oil Conservation Division in New Mexico. On federal leases, the Bureau of Land Management also requires an Application for Permit to Drill for each well [30]. On Indian leases BLM requires one too, and state rules may not apply there [34]. After an APD arrives, BLM “typically conducts an onsite inspection” with the operator, surface and mineral estate owners, and resource specialists [35].

How much oil can I have on site before I need an SPCC plan?

A site that could discharge oil to navigable waters needs a plan above 1,320 US gallons aboveground, counting only containers of 55 gallons or more [8]. Completely buried storage over 42,000 gallons also triggers the rule, not counting buried tanks subject to the federal or state underground storage tank rules [8]. A container that is permanently closed, as the rule defines it, counts toward neither total [8].

How long is an SPCC plan good for?

The operator must review and evaluate an SPCC plan at least once every five years from the date the facility becomes subject to Part 112 [33]. A Professional Engineer certifies any technical amendment, unless the facility qualifies to self-certify [33].

What is the difference between SPCC and FRP?

An SPCC plan is kept at the facility, or at the nearest field office if the site is attended under four hours a day [4]. A facility response plan (FRP) covers responding to a discharge; a facility needs one if it could cause substantial harm, or if EPA requires one [36]. Unlike an SPCC plan, a facility response plan is submitted to EPA [36].

What is a Part 70 air permit?

A Part 70 permit is the Title V operating permit, named after 40 CFR Part 70 [19]. Title V applies to major sources: generally 100 short tons a year of a pollutant, or 10 of one hazardous air pollutant or 25 combined [19]. A Title V permit runs for a term of no more than 5 years, except for certain municipal waste incinerators [37]. When it expires, the source loses its right to operate unless it filed a timely and complete renewal application [38].

Never miss a deadline for Colorado’s yearly oil and gas emissions report, the Oil and Natural Gas Annual Emissions Inventory (ONGAEIR), or for the GHGRP: subscribe for compliance updates and regulatory news.


References

  1. EPA, Class II Oil and Gas Related Injection Wells, updated June 3, 2026. https://www.epa.gov/uic/class-ii-oil-and-gas-related-injection-wells
  2. 40 CFR 144.11, Prohibition of unauthorized injection. https://www.ecfr.gov/current/title-40/section-144.11
  3. 40 CFR 122.26, Storm water discharges. https://www.ecfr.gov/current/title-40/section-122.26
  4. 40 CFR 112.3, Requirement to prepare and implement an SPCC Plan. https://www.ecfr.gov/current/title-40/section-112.3
  5. EPA, Subpart W Petroleum and Natural Gas Systems industry profile, reporting year 2023. https://www.epa.gov/system/files/documents/2024-10/subpartw_profile_2023.pdf
  6. 91 FR 65112, Extending the Reporting Deadline Under the Greenhouse Gas Reporting Rule for Reporting Year 2025 to March 10, 2027, interim final rule, October 14, 2026. https://www.federalregister.gov/documents/2026/10/14/2026-20982/extending-the-reporting-deadline-under-the-greenhouse-gas-reporting-rule-for-reporting-year-2025-to
  7. Federal Register, EPA documents on greenhouse gas reporting, sorted by newest, searched November 3, 2026. https://www.federalregister.gov/api/v1/documents.json?conditions[term]=%22greenhouse+gas+reporting%22&conditions[agencies][]=environmental-protection-agency&order=newest
  8. 40 CFR 112.1, General applicability. https://www.ecfr.gov/current/title-40/section-112.1
  9. EPA, Regulations: Title 40, Code of Federal Regulations. https://www.epa.gov/laws-regulations/regulations
  10. EPA, SPCC Guidance for Regional Inspectors, chapter 2. https://www.epa.gov/sites/default/files/2014-04/documents/2_applicability_2014.pdf
  11. 40 CFR 112.4, Amendment of SPCC Plan by Regional Administrator. https://www.ecfr.gov/current/title-40/section-112.4
  12. 40 CFR Part 110, Discharge of oil. https://www.ecfr.gov/current/title-40/part-110
  13. EPA, Basic Information about Operating Permits. https://www.epa.gov/title-v-operating-permits/basic-information-about-operating-permits
  14. EPA, Primary Enforcement Authority for the Underground Injection Control Program, state table for Hawaii, Iowa, Minnesota, New York, Pennsylvania, Virginia and the District of Columbia, updated October 29, 2026. https://www.epa.gov/uic/primary-enforcement-authority-underground-injection-control-program-0
  15. New Mexico Energy, Minerals and Natural Resources Department, Oil Conservation Division. https://www.emnrd.nm.gov/ocd/
  16. Colorado General Assembly, SB23-285, Energy and Carbon Management Regulation in Colorado. https://leg.colorado.gov/bills/sb23-285
  17. EPA, National Pollutant Discharge Elimination System (NPDES). https://www.epa.gov/npdes
  18. EPA, NPDES State Program Authority, state table including New Mexico, Massachusetts, New Hampshire and Oklahoma. https://www.epa.gov/npdes/npdes-state-program-authority
  19. 40 CFR 70.2, Definitions. https://www.ecfr.gov/current/title-40/section-70.2
  20. 40 CFR 51.160, Legally enforceable procedures. https://www.ecfr.gov/current/title-40/section-51.160
  21. EPA, NPDES Stormwater Program. https://www.epa.gov/npdes/npdes-stormwater-program
  22. 33 U.S.C. 1342(l)(2), Clean Water Act section 402(l)(2). https://www.govinfo.gov/link/uscode/33/1342?link-type=html
  23. EPA, Class VI Wells used for Geologic Sequestration of Carbon Dioxide. https://www.epa.gov/uic/class-vi-wells-used-geologic-sequestration-carbon-dioxide
  24. 49 CFR 192.8, How are onshore gathering pipelines and regulated onshore gathering pipelines determined? https://www.ecfr.gov/current/title-49/section-192.8
  25. 49 CFR 192.5, Class locations. https://www.ecfr.gov/current/title-49/section-192.5
  26. 49 CFR 192.9, What requirements apply to gathering lines? https://www.ecfr.gov/current/title-49/section-192.9
  27. 15 U.S.C. 717f, Natural Gas Act certificates. https://www.govinfo.gov/link/uscode/15/717f?link-type=html
  28. Natural Gas Act section 1(b), exemption for production and gathering, 15 U.S.C. 717(b). https://www.govinfo.gov/link/uscode/15/717?link-type=html
  29. 91 FR 768, Reissuance and Modification of Nationwide Permits, January 8, 2026. https://www.federalregister.gov/documents/2026/01/08/2026-00121/reissuance-and-modification-of-nationwide-permits
  30. 43 CFR 3171.5, Application for Permit to Drill. https://www.ecfr.gov/current/title-43/section-3171.5
  31. 40 CFR 52.21, Prevention of significant deterioration of air quality. https://www.ecfr.gov/current/title-40/section-52.21
  32. 40 CFR 70.5, Permit applications. https://www.ecfr.gov/current/title-40/section-70.5
  33. 40 CFR 112.5, Amendment of SPCC Plan by owners or operators. https://www.ecfr.gov/current/title-40/section-112.5
  34. 25 CFR 1.4, State and local regulation of the use of Indian property. https://www.ecfr.gov/current/title-25/section-1.4
  35. Bureau of Land Management, Oil and Gas Operations and Production. https://www.blm.gov/programs/energy-and-minerals/oil-and-gas/operations-and-production
  36. 40 CFR 112.20, Facility response plans. https://www.ecfr.gov/current/title-40/section-112.20
  37. 40 CFR 70.6, Permit content. https://www.ecfr.gov/current/title-40/section-70.6
  38. 40 CFR 70.7, Permit issuance, renewal, reopenings, and revisions. https://www.ecfr.gov/current/title-40/section-70.7
  39. 90 FR 44591, Reconsideration of the Greenhouse Gas Reporting Program, September 16, 2025. https://www.federalregister.gov/documents/2025/09/16/2025-17923/reconsideration-of-the-greenhouse-gas-reporting-program
  40. 91 FR 9712, Extending the Reporting Deadline Under the Greenhouse Gas Reporting Rule for 2025, February 27, 2026. https://www.federalregister.gov/documents/2026/02/27/2026-03995/extending-the-reporting-deadline-under-the-greenhouse-gas-reporting-rule-for-2025
  41. 91 FR 68234, Additional Reconsideration Standards of Performance for New, Reconstructed, and Modified Sources and Emissions Guidelines for Existing Sources: Oil and Natural Gas Sector Climate Review, proposed rule, October 29, 2026. https://www.federalregister.gov/documents/2026/10/29/2026-22082/additional-reconsideration-standards-of-performance-for-new-reconstructed-and-modified-sources-and

This post is for informational purposes only and does not constitute legal or compliance advice. Consult qualified legal counsel or a compliance professional for guidance specific to your operations and jurisdiction.

Interactive tool

Which permits attach, and in what order

Pick what you are doing. This lists the federal requirements in the order they attach and flags the ones that cannot be obtained after the work has started.

What are you doing?

Must be held before the work starts

3 of 6 requirements

Sequence matters here

In order

  1. Before construction Drilling permit State law; 43 CFR 3171.5 on federal or Indian leases State oil and gas agency; BLM (Form 3160-3 APD) on federal or Indian leases Cannot be obtained after the act
  2. Before construction Preconstruction air authorization (state minor NSR, permit-by-rule or general permit; PSD if major) 40 CFR 51.160; 52.21 State air agency, or EPA where undelegated PSD applies only to a new major source or a major modification Cannot be obtained after the act
  3. Before construction Clean Water Act Section 404 permit 33 U.S.C. 1344 US Army Corps of Engineers, or the state in Michigan and New Jersey Only where fill is placed in waters of the US: pads, roads, pipeline crossings (Nationwide Permit 12 for pipelines) Cannot be obtained after the act
  4. Within six months of operating Spill prevention (SPCC) plan 40 CFR 112.3 Nobody: certified by a licensed PE, or self-certified by a qualified facility (40 CFR 112.6) An oil production facility prepares and implements it within six months after operations begin; other facilities need it before operating
  5. Once operating Title V operating permit 40 CFR 70.5 State air agency, or EPA where undelegated Major sources only; apply within 12 months of becoming subject
  6. Once operating Stormwater permit 33 U.S.C. 1342(l)(2) State NPDES programme or EPA Only after a reportable-quantity discharge or runoff contributing to a water quality violation, or where state law requires one (Colorado requires construction stormwater coverage); other oil and gas runoff is exempt

Federal requirements, from 40 CFR 51.160, 52.21, 70.5, 112.3 and 144.11, 43 CFR 3171.5 and 33 U.S.C. 1342(l)(2) and 1344, read September 29, 2026. Drilling permits are issued by the state oil and gas agency, or by BLM on federal or Indian leases. The SPCC plan is prepared and certified by the operator; no agency issues it. An approved state programme may be more stringent, and this is a sequence reference rather than an applicability determination. Whether a threshold is actually crossed is a separate question with its own tools. Nothing leaves your browser.
